Agenda
and
Business Paper
To be held on
Monday 26
May 2025
at 6:00 PM
Civic Centre cnr Baylis and Morrow Streets,
Wagga Wagga NSW 2650 (PO Box 20)
P 1300 292 442
P council@wagga.nsw.gov.au
wagga.nsw.gov.au
NOTICE OF MEETING
The proceedings of all Council meetings in open session, including all debate and addresses by the public, are recorded (audio visual) and livestreamed on Council’s website including for the purpose of facilitating community access to meetings and accuracy of the Minutes.
In addition to webcasting council meetings, audio recordings of confidential sessions of Ordinary Meetings of Council are also recorded, but do not form part of the webcast.
WAGGA WAGGA CITY COUNCILLORS
STATEMENT OF ETHICAL OBLIGATIONS
Councillors are reminded of their Oath or Affirmation of Office made under Section 233A of the Local Government Act 1993 and their obligation under Council’s Code of Conduct to disclose and appropriately manage Conflicts of Interest.
QUORUM
The quorum for a meeting of the Council, is a majority of the Councillors of the Council, who hold office for the time being, who are eligible to vote at the meeting.
Reports submitted to the Ordinary Meeting of Council to be held on Monday 26 May 2025.
Ordinary Meeting of Council AGENDA AND BUSINESS PAPER
Monday 26 May 2025
CLAUSE PRECIS PAGE
ACKNOWLEDGEMENT OF COUNTRY 2
REFLECTION 2
APOLOGIES 2
Confirmation of Minutes
CM-1 CONFIRMATION OF MINUTES - ORDINARY COUNCIL MEETING - 12 MAY 2025 2
DECLARATIONS OF INTEREST 2
Reports from Staff
RP-1 WAGGA TO LADYSMITH RAIL TRAIL 3
RP-2 LEP24/0001 - Planning Proposal - 92 Cooramin St, Cartwrights Hill 16
RP-3 Dedication of Community Land as Public Road - 55 Plumpton Road, Lake Albert 21
RP-4 FINANCIAL PERFORMANCE REPORT AS AT 30 APRIL 2025 24
RP-5 Gregadoo Road Corridor Strategy amendment to Wagga Wagga Local Infrastructure Contributions Plan 56
RP-6 EXTENSION OF RFT 2023-13 PLACEMENT OF INSURANCE AND PROVISION OF RISK ADVISORY SERVICES 62
RP-7 QUESTIONS WITH NOTICE 64
Confidential Reports
CONF-1 APPOINTMENT OF SISTER CITY WORKING GROUP MEMBERS 68
Wagga Wagga City Council acknowledges the traditional custodians of the land, the Wiradjuri people, and pays respect to Elders past, present and future and extends our respect to all First Nations Peoples in Wagga Wagga.
We recognise and respect their cultural heritage, beliefs and continuing connection with the land and rivers. We also recognise the resilience, strength and pride of the Wiradjuri and First Nations communities
REFLECTION
Councillors, let us in silence reflect upon our responsibilities to the community which we represent, and to all future generations and faithfully, and impartially, carry out the functions, powers, authorities and discretions vested in us, to the best of our skill and judgement.
CM-1 CONFIRMATION OF MINUTES - ORDINARY COUNCIL MEETING - 12 MAY 2025
That the Minutes of the proceedings of the Ordinary Council Meeting held on 12 May 2025 be confirmed as a true and accurate record.
|
1⇩. |
Minutes - Ordinary Council Meeting - 12 May 2025 |
69 |
Report submitted to the Ordinary Meeting of Council on Monday 26 May 2025 |
RP-1 |
Reports from Staff
RP-1 WAGGA TO LADYSMITH RAIL TRAIL
Author: Ben Creighton
Executive: Fiona Piltz
Summary: |
This report provides a detailed overview of the actions undertaken by Council in response to a previous resolution of Council on the Wagga to Ladysmith Rail Trail. The report summarises the outcomes of the project investigations, community engagement, and presents a recommended position for Council’s consideration. |
That Council:
a note the potential benefits and risks of the proposed Wagga Wagga to Ladysmith Rail Trail project
b does not proceed to detailed planning of the Wagga Wagga to Ladysmith Rail Trail project due to the significant unfunded capital and ongoing maintenance costs
c carry out a preliminary inhouse review of the extension of the existing Tumbarumba to Rosewood Rail Trail to Humula
Report
At the Ordinary Meeting of Council held 26 July 2021 it was resolved:
That Council:
a. receive and note the attached petition
b. reaffirm its support (as previously adopted in October 2016, February 2014, and February 2008) for the Wagga Wagga to Ladysmith Rail Trail concept to enable interested parties to make submissions for grant funding
c. approach State and Federal Governments regarding their current position in relation to rail trails
d. undertake a community consultation process with a view to identifying a pathway to pursue a rail trail in the Wagga Wagga Local Government Area (LGA); acknowledging the current active travel plan network
e. receive a further report back to Council prior to 30 April 2022 outlining responses to part (c) and (d) of this resolution
This report provides a detailed overview of the actions undertaken by Council in response to the above resolution, summarises the outcomes of investigations and community engagement, and presents a recommended position for Council’s consideration.
The proposed Wagga Wagga to Ladysmith Rail Trail project would see a sealed, off-road trail connecting Wagga Wagga to the village of Ladysmith. The original trail was proposed to travel from Wagga Wagga CBD to Ladysmith. However, during investigations a revised proposal was considered starting at Forest Hill to align with the Forest Hill Active Travel Plan network.
Stakeholders for many decades have lobbied for the development of the trail along the disused Wagga to Tumbarumba Rail corridor providing an accessible route for walking, running, cycling, and commuting between communities. This has been a divisive issue within the community with Council having previously considered petitions both for and against the proposed rail trail.
Following the Council resolution, a community consultation program was undertaken with landowners, residents, and other stakeholders to understand the community thoughts regarding the Rail Trail. An initial information session and stakeholder meeting were conducted on 24 November 2021. Subsequent engagement activities were carried out throughout early 2022, including written submissions, online consultation opportunities, and direct meetings with impacted landowners.
Feedback received during this process revealed an ongoing significant division within the community. Supporters of the rail trail concept cited the potential benefits to community health, active transport connectivity, tourism growth, and overall regional amenity. Advocates also noted the success of other rail trails in attracting visitors and stimulating local economies. Conversely, opposition to the proposal was strong among many directly impacted landowners. Key concerns raised included:
· Risks to farm biosecurity from public access through agricultural land
· Impacts on daily farming operations and access
· Loss of privacy and potential safety issues for rural residents
· Legal liability concerns and potential costs associated with fencing, maintenance, and access management
In

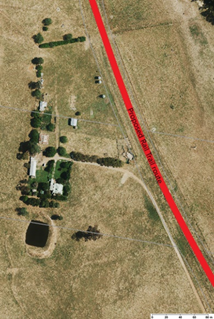

particular it was noted the proximity of the rail corridor to existing rural
buildings.
The consultation undertaken included discussions with representatives from the
Council and proponents of the recently constructed Tumbarumba to Ladysmith Rail
Trail who successfully worked with landowners with farming properties between
Rosewood and Ladysmith. During the initiation phase of their project,
similar concerns were raised by landowners, however through the development of
close working relationships with the landowners they were able to resolve most
concerns to the point where some on the opposed landowners are now the biggest
advocates for the project.

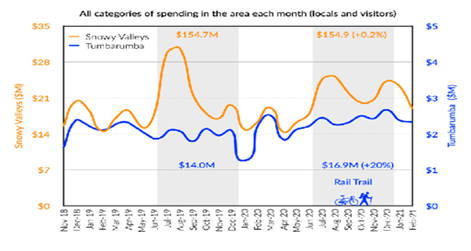

During 2022 Regional NSW released the evaluation report of the pilot rail trail projects and a future framework for Rail Trails development (Attached). In NSW there are two pilot Rail Trail projects being delivered:
1. The Tumbarumba to Rosewood Rail Trail runs for 21kms through the Snowy Valleys local government area in the Snowy Mountains region. It has been operational since April 2020.
2. The Northern Rivers Rail Trail, currently under development. It will run for 132km when completed and traverse Richmond Valley, Lismore City, Tweed Shire, and Byron Shire local government areas. The first 24km section from Murwillumbah to Crabbes Creek opened on 1 March 2023. with the Casino to Bentley section opened in March 2024, Lismore to Bentley section opened in December 2024 and the Byron Bay section under planning and development.
The Rail Trail program was deemed successful. There were inefficiencies in project delivery during the initial stages in both pilot projects, particularly in relation to the legislative amendment process, however, it displayed evidence of delivering positive outcomes against most indicators of success shown below.
· Efficiency of legislative amendment process
o Several opportunities for improvement were identified throughout the process. Of the three indicators, one was considered ‘poor’ due to the time intensive nature of the legislative change process. The other two were considered ‘unsatisfactory’ due to the infancy of the process and level of clarity from agencies around some roles and responsibilities.
· Effectiveness of operational model
o Many aspects of the operational models were effective, particularly how the two pilot projects developed appropriate management structures and governance models, used resources wisely, and built community awareness about the projects.
o Concerns regarding the lack of ongoing funding may impact future maintenance requirements.
o Overall, the effectiveness of the Rail Trails program was considered to have been ‘good.’
· Appropriateness
o The design and delivery of the Tumbarumba to Rosewood Rail Trail was seen to have been appropriate to the needs of the communities it was intending to serve.
o Increasing community awareness over time; increasing positive sentiment over time; and increasing user satisfaction in Tumbarumba all rated ‘excellent.’ Increasing positive sentiment, was rated ‘good.’
· Impact
o The operational impact of the Tumbarumba to Rosewood Rail Trail was considered ‘excellent.’ Two indicators of success were considered, both having performed well, displaying evidence of positive social and economic outcomes.
In addition to the pilot projects, there have been other developments in Rail Trails. The Monaro Rail Trail project is advancing, with planning funding secured for a section between Queanbeyan and Cooma. The New England Rail Trail, which aimed to repurpose the disused Armidale to Glen Innes rail corridor, has stalled following the withdrawal of State Government funding in late 2024. This decision resulted from significant delays in securing access to the rail corridor, which impeded project progress and prevented the necessary grant deadlines from being met. Local advocates are actively working to secure alternative funding to move the project forward.
The NSW Government have developed the Rail Trails Framework to provide clear guidance on the establishment of NSW Rail Trail projects that leverage identified benefits. This identifies Council’s next steps if the Wagga Wagga Rail Trail proposal was to be supported. The below flow chart identifies the planning pathway for the construction and use of a Rail Trail:
As part of the above resolution, Council officers approached both the State and Federal Governments to seek guidance on current policy positions relating to rail trails.
The response indicated that both tiers of government support the development of rail trails, particularly as part of efforts to enhance regional tourism, promote active travel, and diversify local economies. However, it was made clear that support is dependent on projects adhering to the NSW Rail Trails Framework.
The Framework, established following the pilot rail trail projects, outlines a thorough set of requirements that Councils must meet before receiving Government endorsement, including:
• Demonstrated strong community support
• Comprehensive stakeholder consultation, particularly with landowners
• Detailed feasibility studies and business case preparation
• Sustainable governance and maintenance models
• Clear identification of funding sources for construction and long-term maintenance
When queried on the varied levels of community support that this proposal is facing, the response from State agencies was that it would be necessary to demonstrate how Council is managing and addressing this division. No clear guidance was provided on how to specifically navigate or resolve the concerns raised by affected landowners.
As part of broader discussions around the development of regional rail trails, Council staff have held preliminary discussions with UGL, the current leaseholder of the Wagga to Tumbarumba rail corridor. UGL has previously indicated a willingness to consider agreements that facilitate the use of disused rail corridors for public recreation, including rail trails. While no formal agreement has been sought for the Wagga Wagga to Ladysmith section, it appears UGL’s is open to collaboration.
In relation to the Wagga Rail Trail, detailed considerations would need to be made for:
• Ongoing maintenance
o The trail would require regular ongoing maintenance such as how vegetation and surface are managed
o Thoughts would need to go into who is responsible to deliver this ongoing maintenance
• Private property access
o The route has 11 property owners bordering the rail corridor.
o 9 of the 11 properties have land either side of the rail trail route
o Allowance for stock and farm machinery crossings e.g., tunnels, culverts
• Some sections of the proposed route are located on flood plains which would require additional planning and design work
• Large scale investigation would be required to assess whether the existing rail track can be used to develop the trail on top of the rail
• The existing wooden bridges are unable to be used. Alternative options would need to be investigated, including new bridges, box culverts etc.
The Wagga Rail Trail Strategic Directions and Implementation Plan document has identified the benefits recreation trails as:
• Health benefits – by providing an accessible and safe environment to encourage physical activity and healthy lifestyles.
• Social and community benefits – by providing an accessible and cheap transport option for the whole community to use
• Transport benefits – reduced traffic and parking congestion, reduced individual expenses on vehicle maintenance and more efficient land use and infrastructure to encourage multiple travel options
• Environmental benefits – reduced energy consumption and air/noise pollution
• Tourism and economic benefits – Providing infrastructure that will encourage visitors to stay and spend money locally and increase opportunities to organise trail base events and competitions
• The Rail Trails for NSW Evaluation summary document highlighted evidence of substantial increases in economic activity in the Tumbarumba region across a range of measures since the Rail Trail began operation. Spending in the Tumbarumba region increased by 20 per cent from 2019 to 2020 during the June to December periods (from $14.0 million to $16.9 million). It is difficult to attribute Tumbarumba’s economic increases entirely to the Rail Trail, as some would relate it to the easing of COVID-19 restrictions, ongoing international border closures and a resultant increase in domestic and regional tourism. However, the 20 per cent increase in the Tumbarumba region was well above the state average of 12 per cent and substantially above the Snowy Valleys LGA average of 0.2 per cent. Therefore, this increase from June to December 2020 and beyond suggests the Rail Trail played a significant role.
Council officers undertook technical investigations to update preliminary cost estimates and explore potential design options for the proposed trail. High level costing estimates have been undertaken through Council’s in-house Quantity Surveyor as well as the Cordells construction estimate software. Multiple design options were considered with asphalt, chip seal, compacted aggregate and concrete costings estimated. The total estimated construction costs ranged from $16.8M to $19.65M. Detailed estimated costings for each option have been attached. These costings are significantly higher than previously estimated in documents such as the Wagga Rail Trail Strategic Directions and Implementation Plan which estimated the total order of costs at $9.95M.

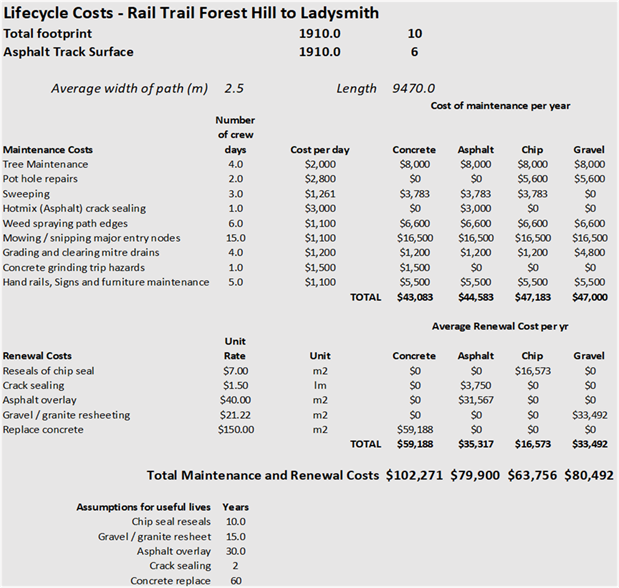

It is important to note that these updated cost estimates were developed through desktop studies only. Due to limitations in project funding and the absence of landowner permissions to access the proposed corridor, site-specific costings could not be developed.
Additionally,
ongoing operational costs for maintenance have been costed by Council Officers
off current rates with estimates ranging from $63,000 to $102,000 per annum.
There is no current funding source for these costs. A detailed breakdown of
maintenance costs and expected asset life are included below:
A Rapid Business Cost Ratio (BCR) model was developed for the proposed Wagga Wagga Rail Trail project in line with State and Federal Government Treasury guidelines. Benefits measured within the model from the proposal included Tourism, Health, Environmental, Safety and Amenity over a 20-year time horizon and these were weighed against project Capital, Operating and Maintenance expenses. Benefits and Expenses were calculated on a Net Present Value basis as per guidelines using a 5% discount rate.
A positive BCR of 1.14 was recorded for the project using NSW State Government methodology which excluded displaced tourism benefits from other areas of NSW. This rose to a BCR 1.46 using Federal Government methodology.
It should be noted that Health Benefits accounted for close to 35% of total Benefits and if these were excluded in the evaluation process the BCR fell to 0.73 (State Methodology) and 1.06 (Federal). Some benefits would be also accrued to people residing outside of the Wagga Wagga LGA.
The following assumptions were used within the model to derive the BCR’s:
Rail Trail |
Assumptions |
Source |
Total Users |
140 per day year 1 boost and then 50 per day - growing 3% per year |
Tumba Rail Trail, Northern Rivers Rail Trail, Vic Rail Trail |
User Location |
Wagga LGA 50%, Riverina Murray 20%, Other NSW 10%, ACT 10%, Victoria 7%, QLD 2%, others 1% |
Tumba Rail Trail, Tourism Research Australia, Visitor Centre Counts |
User Type |
70% Cycling, 10% running, 10% walking, 10% other |
Tumba Rail Trail |
Visitor Spend |
Local $10, Riv Murray $30, Ex-NSW $80, Interstate 40% $100 (family) and 60% $250 (hotel) |
Tourism Research Australia |
Visitor Nights |
1 additional night associated solely with Rail Trail visit |
Tourism Research Australia |
Health - Average Distance per mode |
Cycling 12km, Walking 4KM, Running 5KM, Other 5 KM |
TfNSW |
Health - $ value per KM |
Cycling $2.20 per KM, Other modes $4.39 per KM |
TfNSW |
Environment |
All modes $0.03 per KM |
TfNSW |
Safety |
Accident cost cycling $0.24 per KM, other modes $0.12 per KM |
TfNSW |
Utility |
Population of Ladysmith, Forest Hill Zones at 70% favourable and $17.32 value of leisure time |
TfNSW |
CAPEX |
Asphalt build, 10% mark up, 20% contingency built in years 1 and 2 |
WWCC |
OPEX |
$10,271 per annum, growing by 2% |
WWCC |
Interest Rate |
5% |
NSW Treasury |
Period |
2025-2045 |
WWCC |
During investigations,
staff became aware of growing community momentum supporting an extension of the

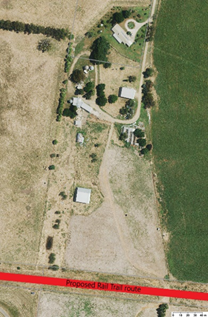

Tumbarumba to Rosewood Rail Trail toward Humula. (see below)
Initial indications suggest this proposal may face less community opposition while offering similar benefits in terms of tourism and local economic growth. Very little information is available on the scope of this project with further preliminary investigations required to determine its feasibility.
Analysis:
· The development of a rail trail between Forest Hill and Ladysmith could offer long-term economic, health and social benefits for the region
· The State Government has adopted a clear framework for the development of Rail Trails.
· Other Rail Trails have overcome landowners concerns during the development and construction of rail trails.
· Market Conditions have changed, and the expected construction and maintenance cost have increased significantly since the Wagga Wagga Rail Trail committee had put their proposal to Council
· Preliminary whole of life cost estimates identified significant capital contributions and ongoing operation costs that are currently unfunded if Council were to proceed with the project.
· There is significant ongoing division within the community.
· Within Council, there are several major infrastructure and community projects competing for limited external and internal funding sources. If there is a desire to progress the Wagga to Ladysmith Rail Trail it should be considered alongside other Council priorities given the substantial capital and ongoing operational costs involved.
· Securing grant funding for a project of this scale may also limit Council’s capacity to pursue or co-fund other high-priority initiatives in the short to medium term.
Resolution Options:
a. note the potential benefits and risks of the proposed Wagga Wagga to Ladysmith Rail Trail project
b. does not proceed to detailed planning of the Wagga Wagga to Ladysmith Rail Trail project due to the significant unfunded capital and ongoing maintenance costs
c. endorse staff carrying out a preliminary inhouse review of the extension of the existing Tumbarumba to Rosewood Rail Trail to Humula
Council does not have the significant capital or operational funding to deliver the project currently. This project is not identified as a priority when compared to other projects identified as priorities through adopted strategic documents. This option also allows for an inhouse preliminary review the Rosewood to Humula extension to assess the potential benefits, costs and feasibility of the project.
Cost: Approximately 40-50 hours of staff time that is already funded.
Option 2 – Do not proceed with Wagga to Ladysmith Project or the Internal Investigation into Rosewood to Humula extension
a. note the potential benefits and risks of the proposed Wagga Wagga to Ladysmith Rail Trail project
b. does not proceed to detailed planning of the Wagga Wagga to Ladysmith Rail Trail project due to the significant unfunded capital and ongoing maintenance costs
c. does not proceed with carrying out a preliminary inhouse review of the extension of the existing Tumbarumba to Rosewood Rail Trail to Humula
Council does not have the significant Capital or operation funding to deliver the project currently. This project is not identified as a priority when compared to other projects identified as priorities through adopted strategic documents. This option also would not pursue the inhouse review of the Rosewood to Humula rail trail extension.
Cost: N/A
a. note the potential benefits and risks of the proposed Wagga Wagga to Ladysmith Rail Trail project
b. endorse proceeding to detailed planning of the Wagga Wagga to Ladysmith Rail Trail project
c. endorse carrying out a preliminary inhouse review of the extension of the existing Tumbarumba to Rosewood Rail Trail to Humula
d. approve the budget variations as noted in the financial implications section of this report for option 3.
In this option staff would proceed with the detailed planning that would be required to seek grant funding and approvals for the project. This would include: the development of a concept design, geotechnical investigations, detailed cost estimates, the development of a REF and detailed business case. The estimated cost of completing these investigations would be:
Cost |
|
Concept design |
$90,000 |
Geotechnical investigations |
$25,000 |
Detailed cost estimates |
$10,000 |
Development of a REF |
$30,000 |
Development of detailed business case |
$55,000 |
Consultation |
$10,000 |
Project Management |
$20,000 |
Total |
$240,000 |
There is no identified funding source for these planning activities. If they were to proceed, and due to limited Council internal reserves available for this type of expenditure, it is proposed that the above $240,000 be funded from external loan borrowings, with the future year repayments to be considered during the compilation of the 2026/27 Long Term Financial Plan.
If following the detailed investigations Council chose to proceed with the project, grant funding and co-contribution funding would need to be sourced. If grant funding was not forthcoming then the capital funding of an estimated $16.8M – $19.65M would need to be funded by either internal or external loan borrowings, a Special Rate Variation (SRV), or a reduced or changed operational plan where funds are diverted from projects or initiatives that exist within the LTFP to fund the project.
The likelihood of grant funding of this magnitude being available for this type of project is unknown. However, it is likely that many of the grant funding programs that would be suitable for this project would also be suitable for other strategic priorities such as Airport upgrades.
Future operational costs (i.e. maintenance of the trail) will also need to be built into an asset management plan and funded.
Option 4 – Proceed with detailed investigations into Wagga to Ladysmith Project but do not proceed with the Internal Investigation into Rosewood to Humula extension
That Council:
a. note the potential benefits and risks of the proposed Wagga Wagga to Ladysmith Rail Trail project
b. endorse proceeding to detailed planning of the Wagga Wagga to Ladysmith Rail Trail project
c. do not proceed with preliminary inhouse review of the extension of the existing Tumbarumba to Rosewood Rail Trail to Humula
d. approve the budget variations as noted in the financial implications section of this report for option 4.
In this option Council would proceed with the detailed planning that would be required to seek grant funding and approvals for the project but not proceed with the internal investigations into the Rosewood to Humula extension.
The cost implications for this option would be the same as Option 3 for the initial planning and then if the project proceeded the construction and operational stages of the project.
40-50 hours of staff time would not need to be allocated to this project if the inhouse review of the Rosewood to Humula extension did not proceed.
Financial Implications
If Option 1 or 2 are adopted there are no additional funding implications.
If Option 3 or 4 were to be endorsed, the estimated cost of completing the detailed investigations totals $240,000. This is currently unfunded. It is proposed that these activities would be funded by external loan borrowings, with the future year repayments to be considered during the compilation of the 2026/27 Long Term Financial Plan.
If the project were to progress, current high-level construction cost estimates for the proposed trail range from $16.8 million to $19.65 million. Annual maintenance costs are estimated between $63,000 and $102,000. No funding is identified in the Long-Term Financial Plan for these activities
Policy and Legislation
Transport Administration Amendment (Rail Trails) Act 2022
Link to Strategic Plan
Safe and Healthy Community
Objective: Our community embraces healthier lifestyle choices and practices
Promote access and participation for all sections of the community to a full range of sports and recreational activities
Risk Management Issues for Council
If this project were to be implemented, the associated risks would relate to process, cost, environmental factors, workplace health and safety (WHS), and contractor performance. These risks are managed through Council’s established project management and contractor performance management systems.
Internal / External Consultation
Council has received multiple petitions in support and against the Rail Trail proposal. The petitions were considered at Council meetings on 26 July 2021 and 25 October 2021.
An initial meeting with proponents and landowners adjacent to the rail corridor between Wagga Wagga and Ladysmith was held on the 24th of November 2021. Following this, additional stakeholder and landowner discussions were undertaken during 2022.
During the development of this report and economic analysis in 2024 and early 2025, multiple stakeholder and landowner discussions were held to update groups of the process and gather relevant information and data.
1. |
Rail Trail Map - Provided under separate cover |
|
2. |
Rail Trail Map - Properties - Provided under separate cover |
|
3. |
NSW Rail Trails Framework - Provided under separate cover |
|
4. |
Wagga Rail Trail Strategic Directions and Implementation Plan - Provided under separate cover |
|
5. |
Evaluation of Rail Trails in NSW - Provided under separate cover |
|
6. |
Rail Trail RAPID BCR June 2024 - Provided under separate cover |
|
7. |
Cost Estimates This matter is considered to be confidential under Section 10A(2) of the Local Government Act 1993, as it deals with: information that would, if disclosed, confer a commercial advantage on a person with whom the Council is conducting (or proposes to conduct) business. - Provided under separate cover |
|
Report submitted to the Ordinary Meeting of Council on Monday 26 May 2025 |
RP-2 |
RP-2 LEP24/0001 - Planning Proposal - 92 Cooramin St, Cartwrights Hill
Author: Hayden Bousfield
Executive: John Sidgwick
Summary: |
Council is in receipt of a planning proposal to amend the Wagga Wagga Local Environmental Plan 2010 to include “function centre” as an additional permitted land use for 92 Cooramin Street, Cartwrights Hill. |
That Council:
a endorse planning proposal LEP24/0001 to amend the Wagga Wagga Local Environmental Plan 2010, Schedule 1, Additional Permitted Uses
b write to the Department of Planning, Housing and Infrastructure (DPHI) requesting a gateway determination under s3.34 of the Environmental Planning & Assessment Act 1979 (EP&A Act)
c on receipt of a Gateway Determination under section 3.34 of the Environmental Planning & Assessment Act 1979, Council enact all the requirements of the Gateway Determination and requirements of Schedule 1, clause 4 of the Environmental Planning & Assessment Act 1979
d delegate authority to the General Manager or their delegate of all functions under section 3.36 of the Environmental Planning and Assessment Act 1979 to make the local environmental plan and put into effect the Planning Proposal
e delegate authority to the General Manager or their delegate to make any variations to the planning proposal, to correct any drafting errors or anomalies to ensure consistency with the Gateway Determination or to address any other matter that may arise during the amendment process
f receive a further report after exhibition period addressing any submissions made in respect of the planning proposal
Planning Proposal Application Details
Applicant: |
Peter Carney – Chief Operating Officer, Harness Racing NSW |
Subject Land: |
Street Address: 92 Cooramin Street, Cartwrights Hill Legal Description: Lot 10, DP 1247474 |
Landowner: |
Harness Racing NSW Racecourse Development Fund |
Report
1. Proposal
Council is in receipt of a draft planning proposal to amend Schedule 1 – ‘Additional Permitted Uses’ in the Wagga Wagga Local Environmental Plan 2010. The proposal seeks to include “function centre” as an additional permitted land use.
The intended outcome is to allow for the establishment of a private function and events hire premise associated with the Riverina Paceway clubhouse. The private function and events hire premise would then be intended to supplement existing paceway activities.
The proponent is required to lodge the planning proposal for an additional permitted use as the subject site sits within the RU1 Primary Production zone where a “function centre” is listed as prohibited.
2. Site and Locality
The Riverina Paceway (the site) is located at 92 Cooramin Street, Cartwrights Hill (Lot 10, DP1247474). Located approximately 4km north from the Wagga Wagga Central Business District, the site sits within a rural area and is surrounded by large lot rural residential properties. The site is approved and currently operates as a “recreational facility (major)” for harness racing.
3. Key Considerations
The planning proposal has been assessed against Council’s strategies, policies and guidelines, and the Local Environmental Plan Making Guideline (DPE, August 2023) for preparing planning proposals. The key considerations are identified below, and the full assessment report is provided as Attachment 1.
Council’s Vision or Strategic Intent
· Riverina Murray Regional Plan 2040
The Riverina Murray Regional Plan 2040 (Regional Plan) identifies the need to build resilience in rural land uses and support the development of the visitor economy. The aim is to protect and support rural enterprises and development greater attraction in the region.
The planning proposal would enable an existing rural place to diversify and develop commercial resilience whilst also providing an existing visitor economy attracter with an additional capability.
· Local Strategic Planning Statement (LSPS) - Wagga Wagga 2040
The Local Strategic Planning Statement (LSPS) 2040 is Council’s long-term strategic planning blueprint for the next 20-years. It considers issues of strategic significance to Wagga Wagga, which guides and supports the introduction of new planning policies, strategies and actions related to land use planning.
The LSPS supports the planning proposal as it would enable the LEP and DCP to support outcomes that support the visitor economy and provides economic resilience for a rural property.
Local Environmental Plan (LEP) Provisions
· Schedule 1 – Additional Permitted Uses
The proposed changes to the LEP will result in amendment to the Schedule 1 – Additional Permitted Uses as follows:
“7 Use of Certain Land at 92 Cooramin Street, Cartwrights Hill
(1) This Clause applies to land at 92 Cooramin Street, being Lot 10 DP 1247474.
(2) Development for the purpose of “Function Centre” is permitted with development consent.”
Environmental Effects
· Acoustics
A Noise Impact Assessment was submitted with the planning proposal which evaluated the additional permitted use (function centre) against the relevant NSW EPA Noise Policy for Industry (NPI) and guidelines set out by the NSW Office of Liquor and Gaming.
The Noise Impact Assessment considered noise emissions from the clubhouse, factoring in a maximum of 285 patrons (excluding staff), background music and operations between 9am – 5pm Monday – Thursday and 9am – 12am (midnight) Friday – Sunday, and noise from increased traffic movements from the existing car park.
The assessment concluded that external noise emissions from the function centre (clubhouse) would be within compliant levels of the Liquor and Gaming NSW noise criteria, excluding an assessment from 12:00am (midnight) – 7:00am, where the proposed usage would unlikely comply due to more stringent requirements and levels.
· Traffic, Access and Parking
The planning proposal is accompanied by a traffic impact assessment (TIA) that has considered the current and proposed traffic conditions. The TIA concluded that there was sufficient parking on site to enable a function centre accommodating the proposed 285 patron (excluding staff), and that the traffic from the function centre would not adversely affect the intersection of Cooramin St and Hampden Avenue.
Financial Implications
In accordance with Council’s 2023/24 Fees and Charges, a Standard LEP Amendment Fee of $11,970.00 applied at the time of the application being submitted. The proponent has paid these fees.
It is anticipated that the LEP amendment will result in a development application in the future for a function centre, in association with the use of the land as recreation facility (major), being the Riverina Paceway. Council’s contribution plans and development servicing plans enable Council to levy contributions and developer charges based on the likely increased demands that the new development will have.
Policy and Legislation
Environmental Planning and Assessment Act 1979
Wagga Wagga Local Strategic Planning Statement – Wagga Wagga 2040
Wagga Wagga Local Environmental Plan 2010
Link to Strategic Plan
Regional Leadership
Vision for the future
Adopt a sound approach to strategic planning to ensure that we are preparing for future growth requirements of the city.
Risk Management Issues for Council
The planning proposal has been assessed and it is recommended it be submitted to NSW Department of Planning and Environment for Gateway Determination. If issued, the determination will require public and agency consultation. Consultation may highlight issues not evident during the assessment.
Internal / External Consultation
Formal public consultation with agencies, adjoining landowners and the public will occur if Gateway Determination is received.
Proposed consultation methods are indicated in the table below:
|
|
Traditional Media |
Community Engagement |
Digital |
||||||||||||
Rates notices insert |
Direct mail |
Letterbox drop |
Council news |
Media release |
Media opportunity |
TV/radio advertising |
One-on-one meeting(s) |
Community meeting(s) |
Stakeholder workshop(s) |
Drop-in session(s) |
Survey/feedback form(s) |
Have your Say |
Email newsletter |
Social media |
Website |
|
Consult |
|
ü |
|
ü |
|
|
|
|
|
|
|
ü |
ü |
1. |
Attachment 1 - Planning Proposal Report Rev 3.0 - Provided under separate cover |
|
2. |
Attachment 2 - Noise Impact Assessment Rev 4 - Provided under separate cover |
|
3. |
Attachment 3 - Traffic Impact Assessment - Provided under separate cover |
|
4. |
Attachment 4 - RCA Final Acoustic Peer Review Report - Provided under separate cover |
|
5. |
LEP24/0002 - Final Assessment Report - Provided under separate cover |
|
Report submitted to the Ordinary Meeting of Council on Monday 26 May 2025 |
RP-3 |
RP-3 Dedication of Community Land as Public Road - 55 Plumpton Road, Lake Albert
Author: Karen Owen
Executive: Fiona Piltz
Summary: |
This report seeks Council endorsement to the dedication of a strip of community land at 55 Plumpton Road, Lake Albert for road purposes to facilitate the duplication of Plumpton Road project. |
That Council:
a endorse proceeding with the proposed dedication of Lot 1 in DP 45491 for road widening purposes pursuant to section 47F of the Local Government Act and section 10 of the Road Act 1993 as outlined in this report
b authorise the General Manager, or their delegate to complete and execute any necessary documents on behalf of the Council
c authorise the General Manager, or their delegate to take such further steps as necessary to complete the proposed dedication of land for road widening purposes including publication of a gazettal notice in the NSW Government Gazette
d authorise the affixing of Council’s common seal to all relevant documents as required
Report
Council is the registered proprietor of 55 Plumpton Road, Lake Albert (being Lot 1 in DP 45491) which is approximately 1.32ha. The parcel of land, which effectively serves as a nature strip, has been owned by Council since 1984, and is currently classified as community land and zoned for recreational purpose.
Figure 1 below shows the location of the nature strip highlighted in green and outlined in red.
Figure 1: Diagram of Lot 1 DP 45491
Council has received significant NSW Government funding under the Accelerated Infrastructure Fund for the duplication of Plumpton Road. To facilitate the project, the Major Projects team have identified that this portion of land will need to be dedicated for road widening purposes.
Council does not have a current plan of management for this parcel of land, and therefore there is not a current permitted pathway under a Plan of Management that would permit the construction of the road. The utilisation of community land for road purposes would also generally not be permitted under the Local Government Act 1993. However, Section 47F(2)(a) confirms that the prohibition on dedication of community land as public road does not apply to “a dedication of land for the purpose of widening an existing public road.”
It is therefore recommended that Council endorse the dedication of the parcel of land referred to in this report for road purposes. If this approach is endorsed by Council, the next steps would be to arrange to publish a gazettal notice in the NSW Government Gazette pursuant to Section 10 of the Roads Act 1993. On publication of the gazettal notice, the nature strip will be formally dedicated as a road parcel.
The only costs to be incurred by Council in finalising this matter would be that Council will need to lodge an 11R notification with Land Registry Services notifying it of the dedication of the road parcel for road purposes. These costs could be funded out of the existing Property Legal Fees budget line.
Financial Implications
If the recommendation is endorsed, the estimated costs to Council as at the date of this report would be legal fees of up to $440 and a registration fee of $171.40. These costs may increase if works extend beyond 30 June 2025.
This amount will be funded from the existing Property Legal Budget Line 10-16750-7170 which has adequate funds available.
Policy and Legislation
Local Government Act 1993
Roads Act 1993
Link to Strategic Plan
Growing
Enabling infrastructure
Provide essential infrastructure; including sewer, roads, key housing enabling infrastructure to support growth.
Risk Management Issues for Council
Council has a responsibility to appropriately use and manage its property assets. The proposed recommendation sets out a formal pathway as to how Council can validly utilise the portion of Plumpton Road required for the road construction.
Failure to identify a valid pathway to undertake this work would impact on the delivery of the Plumpton Road duplication works pursuant to the AIF Funding Agreement.
Internal / External Consultation
Internal consultation has been undertaken within Council’s Economy Business and Workforce Directorate and with the Major Projects Team
Report submitted to the Ordinary Meeting of Council on Monday 26 May 2025 |
RP-4 |
RP-4 FINANCIAL PERFORMANCE REPORT AS AT 30 APRIL 2025
Author: Carolyn Rodney
Summary: |
This report is for Council to consider information presented on the 2024/25 budget and Long-Term Financial Plan, and details Council’s external investments and performance as at 30 April 2025. |
That Council:
a approve the proposed 2024/25 budget variations for the month ended 30 April 2025 and note the balanced budget position as presented in this report
b approve the proposed budget variations to the 2024/25 Long Term Financial Plan Capital Works Program including new projects and timing adjustments
c note the Responsible Accounting Officer’s reports, in accordance with the Local Government (General) Regulation 2021 (Part 9 Division 3: Clause 203) that the financial position of Council is satisfactory having regard to the original estimates of income and expenditure and the recommendations made above
d note the details of the external investments as at 30 April 2025 in accordance with section 625 of the Local Government Act 1993
e accept the grant funding offers as presented in this report
Report

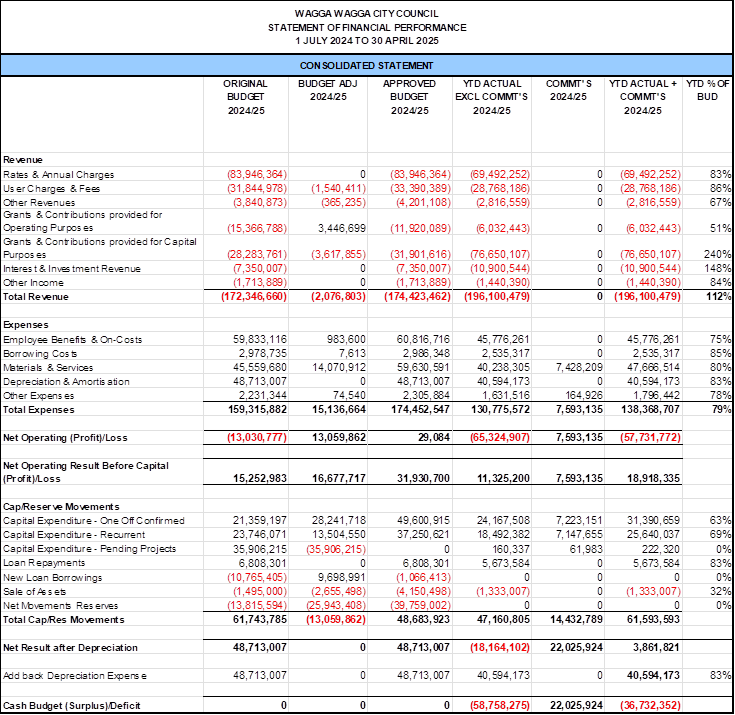

Wagga Wagga City Council (Council) forecasts a balanced budget position as of 30 April 2025.
Proposed budget variations including adjustments to the capital works program are detailed in this report for Council’s consideration and adoption.
Council has experienced a positive monthly investment performance for the month of April when compared to budget ($390,246 up on the monthly budget). This is mainly due to better than budgeted returns on Council’s investment portfolio, as well as a higher than anticipated investment portfolio balance – which is partly due to Council receiving upfront payment of $48.5M in funding under the Accelerated Infrastructure Fund in June 2024.

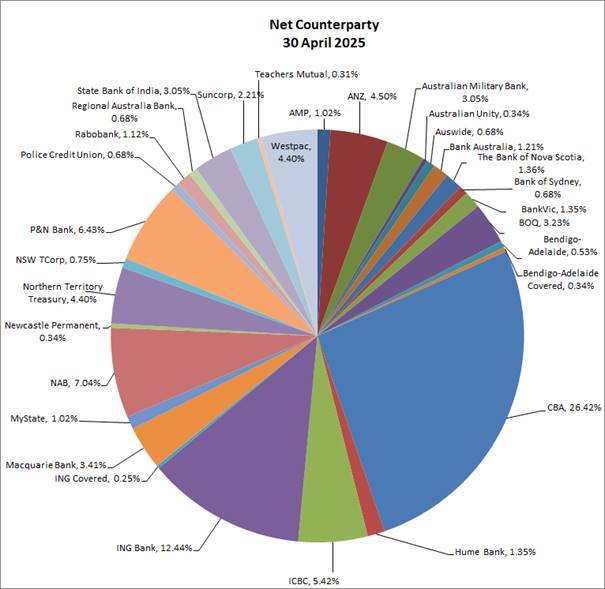

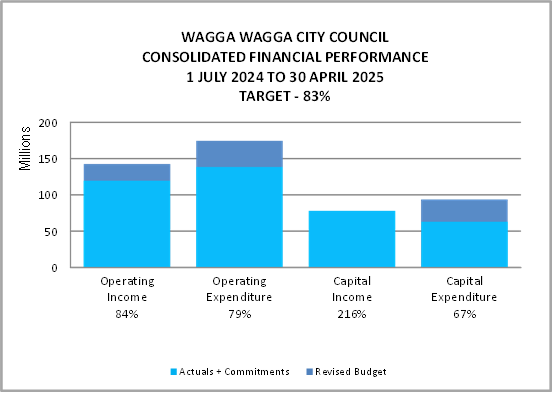

Key Performance Indicators
OPERATING INCOME
Total operating income is 84% of approved budget and is tracking on budget for the month of April 2025. An adjustment has been made to reflect the levy of rates that occurred at the start of the financial year. Excluding this adjustment, operating income received is 93% when compared to budget.
OPERATING EXPENSES
Total operating expenditure is 79% of approved budget and is tracking under budget at this stage of the financial year.
CAPITAL INCOME
Total capital income is 216% of approved budget, which is mainly attributed to the Accelerated Infrastructure Fund (AIF) grant funding that has been received. If this up-front grant funding is not fully spent in this financial year, the income will be reduced and carried over to next financial year for completion of the project.
CAPITAL EXPENDITURE
Total capital expenditure including commitments is 67% of approved budget. Excluding commitments, the total expenditure is 52% when compared to the approved budget.

*Please note that Council has recently reviewed the 2025/26 Long Term Financial Plan, with the draft plan currently on public exhibition. The above table is the current adopted position and not the draft plan not yet adopted.
2024/25 Revised Budget Result – (Surplus) / Deficit |
$’000s |
Original 2024/25 Budget Result as adopted by Council Total Budget Variations approved to date Budget Variations for April 2025 |
$0K $0K $0K |
Proposed Revised Budget result for 30 April 2025 - (Surplus) / Deficit |
$0K |
The proposed Operating and Capital Budget Variations for 30 April 2025 which affect the current 2024/25 financial year are listed below.
Budget Variation |
Amount |
Funding Source |
Net Impact (Fav)/ Unfav |
|
2 – Safe and Healthy Community |
|
|||
Rawlings Park Scout Hall Demolition |
$51K |
Scouts NSW Contribution ($51K) |
Nil |
|
Council has reached an agreement with Scouts NSW to manage the demolition of the former Scout Hall at Rawlings Park with all costs associated with the demolition works to be reimbursed in full by Scouts NSW. Estimated Completion: 30 June 2025 Job Number: 24272 |
|
|||
3 – Growing Economy |
|
|||
$30K |
Internal Loans Reserve (Repaid by Airport Reserve) ($30K) |
Nil |
||
A section of the slab in the airport baggage security area has developed cracks, which WWCC has been monitoring over time. Recently, Council Officers have observed that the cracks are widening, and the slab is sinking, leading to damage in the airport management office, restrooms and the buckling of the sheets. It is imperative that we address this issue promptly to ensure the continuous operation of the airport. Council is currently conducting investigative work and consulting with structural engineers to determine the most effective method for remediation. The following tasks must be completed as soon as possible: - Surveying the steel structure and addressing level discrepancies of the slab - Service search - Consultation with Structural Engineers - Soil testing Once these reports are finalised, the Structural Engineer will recommend a solution, allowing us to determine the total costs, including the setup of a temporary office and rectification efforts. Estimated Completion: 30 June 2025 Job Number: 47335
|
|
|||
4 – Community Place and Identity |
|
|||
Joel Bray Garabari Show |
$10K |
GrainCorp Grant Income ($10K) |
Nil |
|
Council has been successful in securing one-off funding support for the ‘Wiradyuri Youth: Dance on Country’ dance project ‘Garabari’ through the GrainCorp Community Foundation. This one-off $10,000 grant will fund the delivery of a mentoring and workshop program at no cost to young participants with the aim to reduce barriers, and increase access to arts and cultural experiences, specifically one that celebrates Wiradjuri stories and culture. The funding will also support local public schools to undertake workshops, provide buses for nearby rural villages to attend the performance and provide a ticket subsidy to ensure accessibility for First Nations community members. The Civic Theatre will present GARABARI a contemporary dance celebration inspired by corroboree, developed in the Riverina in partnership with Elders, that tells the story of the creation of the mighty Murrumbidgee River later this year from 22 – 24 October 2025. Job Number: 23985 |
|
|||
The following one-off capital project has been reviewed as part of the ongoing budget review process with the adjustments to the timing of the budget being included below for adoption. There is no proposed change to the total budget for the project.
Job No. |
Project Title |
2024/25 Current One-Off Confirmed |
2024/25 Proposed One-Off Confirmed |
2027/28 Current One-Off |
2027/28 Proposed One-Off |
45125 |
LMC – Refurbish Agents Offices & Canteen
|
0 |
150,000 |
500,000 |
350,000 |
*Please note that Council has recently reviewed the 2025/26 Long Term Financial Plan, with the draft plan currently on public exhibition. Future year budget variations will not be processed until after 1 July 2025.
2024/25 Capital Works Summary
Approved Budget |
Proposed Movement |
Proposed Budget |
|
One-off |
$49,600,915 |
$180,000 |
$49,780,915 |
Recurrent |
$37,250,621 |
$0 |
$37,250,621 |
Pending |
$0 |
$0 |
$0 |
Total Capital Works |
$86,851,536 |
$180,000 |
$87,031,536 |
Current Restrictions
RESERVES SUMMARY |
|||||
30 APRIL 2025 |
|||||
|
CLOSING BALANCE 2023/24 |
ADOPTED RESERVE TRANSFERS 2024/25 |
BUDGET VARIATIONS APPROVED UP TO COUNCIL MEETING 28.04.2025 |
PROPOSED CHANGES for Council Resolution* |
BALANCE AS AT 30 APRIL 2025 |
|
|
|
|
|
|
Externally Restricted |
|
|
|
|
|
Developer Contributions - Section 7.11 |
(35,346,092) |
3,828,593 |
(1,278,645) |
|
(32,796,145) |
Developer Contributions - Section 7.12 |
(849,883) |
(28,096) |
104,075 |
|
(773,904) |
Developer Contributions - Stormwater Section 64 |
(8,765,571) |
131,291 |
(990,437) |
|
(9,624,717) |
Sewer Fund |
(52,652,543) |
(276,425) |
(667,266) |
|
(53,596,234) |
Solid Waste |
(31,897,464) |
2,924,014 |
1,086,621 |
|
(27,886,829) |
Specific Purpose Unexpended Grants & Contributions |
(58,467,746) |
0 |
58,467,746 |
|
0 |
SRV Levee Reserve |
(6,230,711) |
0 |
0 |
|
(6,230,711) |
Stormwater Levy |
(5,505,698) |
2,772,743 |
(1,880,677) |
|
(4,613,632) |
Total Externally Restricted |
(199,715,707) |
9,352,119 |
54,841,416 |
0 |
(135,522,172) |
|
|
|
|
|
|
Internally Restricted |
|
|
|||
Additional Special Variation (ASV) |
(934,841) |
934,841 |
0 |
|
0 |
Airport |
0 |
0 |
0 |
|
0 |
Art Gallery |
(15,398) |
(6,000) |
0 |
|
(21,398) |
Bridge Replacement |
(277,544) |
0 |
277,543 |
|
(1) |
Buildings |
(3,386,635) |
77,514 |
516,130 |
|
(2,792,992) |
CCTV |
(34,995) |
0 |
0 |
|
(34,995) |
Cemetery |
(1,378,480) |
(204,757) |
150,870 |
|
(1,432,366) |
Civic Theatre |
(95,013) |
(21,237) |
30,000 |
|
(86,250) |
Civil Infrastructure |
(11,521,350) |
696,586 |
865,846 |
|
(9,958,917) |
Council Election |
(427,970) |
372,507 |
0 |
|
(55,463) |
Economic Development |
(361,938) |
18,358 |
291,936 |
|
(51,645) |
Emergency Events Reserve |
(252,702) |
(109,381) |
0 |
|
(362,084) |
Employee Leave Entitlements Gen Fund |
(3,607,285) |
0 |
0 |
|
(3,607,285) |
Environmental Conservation |
(116,578) |
0 |
0 |
|
(116,578) |
Event Attraction |
(962,294) |
91,784 |
601,625 |
|
(268,885) |
Financial Assistance Grants in Advance |
(10,947,037) |
0 |
10,947,037 |
|
0 |
Grant Co-Funding |
(500,000) |
180,000 |
140,000 |
|
(180,000) |
Gravel Pit Restoration |
(790,095) |
3,333 |
222,825 |
|
(563,936) |
Information Services |
(2,387,681) |
1,037,601 |
(1,552,626) |
|
(2,902,706) |
Insurance Variations |
(50,000) |
0 |
0 |
|
(50,000) |
Internal Loans |
(7,841,730) |
(149,108) |
(821,596) |
30,000 |
(8,782,434) |
Lake Albert Improvements |
(741,740) |
(21,261) |
84,689 |
|
(678,312) |
Library |
(400,985) |
(237,430) |
0 |
|
(638,415) |
Livestock Marketing Centre |
(8,324,132) |
1,013,875 |
2,457,827 |
150,000 |
(4,702,431) |
Museum Acquisitions |
(48,476) |
4,378 |
0 |
|
(44,099) |
|
CLOSING BALANCE 2023/24 |
ADOPTED RESERVE TRANSFERS 2024/25 |
BUDGET VARIATIONS APPROVED UP TO COUNCIL MEETING 28.04.2025 |
PROPOSED CHANGES for Council Resolution* |
BALANCE AS AT 30 APRIL 2025 |
Net Zero Emissions |
(262,207) |
(80,157) |
0 |
|
(342,364) |
Oasis Reserve |
(1,201,931) |
476,905 |
(369,018) |
|
(1,094,044) |
Parks & Recreation Projects |
(2,520,071) |
21,556 |
1,928,172 |
|
(570,343) |
Parks Water |
(180,000) |
20,593 |
0 |
|
(159,407) |
Planning Legals |
(61,747) |
(20,000) |
0 |
|
(81,747) |
Plant Replacement |
(6,383,440) |
227,092 |
2,966,150 |
|
(3,190,197) |
Project Carryovers |
(8,548,629) |
0 |
8,508,604 |
|
(40,025) |
Public Art |
(225,215) |
0 |
186,495 |
|
(38,720) |
Service Reviews |
(100,000) |
0 |
0 |
|
(100,000) |
Sister Cities |
(30,590) |
0 |
0 |
|
(30,590) |
Stormwater Drainage |
(110,178) |
0 |
0 |
|
(110,178) |
Strategic Real Property |
(1,949,243) |
50,000 |
(2,127,600) |
|
(4,026,843) |
Subdivision Tree Planting |
(516,648) |
20,000 |
0 |
|
(496,648) |
Unexpended External Loans |
(602,525) |
68,176 |
935 |
|
(533,413) |
Visitors Economy |
(33,394) |
(24,792) |
0 |
|
(58,186) |
Workers Compensation |
(155,010) |
22,500 |
0 |
|
(132,510) |
Total Internally Restricted |
(78,285,726) |
4,463,475 |
25,305,844 |
180,000 |
(48,336,407) |
|
|
|
|
|
|
Total Restricted |
(278,001,433) |
13,815,594 |
80,147,260 |
180,000 |
(183,858,578) |
|
|
|
|
|
|
Total Unrestricted |
(11,426,000) |
0 |
0 |
0 |
(11,426,000) |
|
|
|
|
|
|
Total Cash, Cash Equivalents, and Investments |
(289,427,433) |
13,815,594 |
80,147,260 |
180,000 |
(195,284,578) |
Investment Summary as at 30 April 2025
In accordance with Regulation 212 of the Local Government (General) Regulation 2021, details of Wagga Wagga City Council’s external investments are outlined below.
Institution |
Rating |
Closing
Balance |
Closing
Balance |
April
EOM |
April |
Investment |
Maturity |
Term |
At Call Accounts |
|
|
|
|
|
|
|
|
NAB |
AA- |
158,995 |
226,693 |
4.10% |
0.08% |
N/A |
N/A |
N/A |
CBA |
AA- |
4,776,208 |
3,044,668 |
4.10% |
1.03% |
N/A |
N/A |
N/A |
CBA |
AA- |
17,900,074 |
16,934,741 |
4.15% |
5.73% |
N/A |
N/A |
N/A |
Macquarie Bank |
A+ |
10,027,445 |
10,060,384 |
3.90% |
3.41% |
N/A |
N/A |
N/A |
CBA |
AA- |
48,930,787 |
48,970,254 |
4.10% |
16.58% |
N/A |
N/A |
N/A |
Total At Call Accounts |
|
81,793,509 |
79,236,740 |
4.09% |
26.83% |
|
|
|
Short Term Deposits |
|
|
|
|
|
|
|
|
AMP |
BBB+ |
2,000,000 |
2,000,000 |
5.10% |
0.68% |
16/12/2024 |
16/09/2025 |
9 |
ING Bank |
A |
1,000,000 |
1,000,000 |
5.31% |
0.34% |
3/06/2024 |
3/06/2025 |
12 |
BankVic |
BBB+ |
2,000,000 |
2,000,000 |
5.34% |
0.68% |
26/06/2024 |
26/06/2025 |
12 |
Bank of Sydney |
NR |
2,000,000 |
2,000,000 |
5.47% |
0.68% |
28/06/2024 |
30/06/2025 |
12 |
NAB |
AA- |
1,000,000 |
1,000,000 |
5.30% |
0.34% |
30/07/2024 |
30/07/2025 |
12 |
NAB |
AA- |
2,000,000 |
2,000,000 |
5.45% |
0.68% |
2/07/2024 |
2/07/2025 |
12 |
NAB |
AA- |
2,000,000 |
2,000,000 |
5.40% |
0.68% |
8/07/2024 |
8/07/2025 |
12 |
Suncorp |
AA- |
1,000,000 |
1,000,000 |
5.43% |
0.34% |
10/07/2024 |
10/07/2025 |
12 |
NAB |
AA- |
2,000,000 |
2,000,000 |
5.03% |
0.68% |
27/08/2024 |
27/08/2025 |
12 |
ICBC |
A |
1,000,000 |
1,000,000 |
5.20% |
0.34% |
14/11/2024 |
14/11/2025 |
12 |
NAB |
AA- |
2,000,000 |
2,000,000 |
5.11% |
0.68% |
28/11/2024 |
28/11/2025 |
12 |
MyState |
BBB |
2,000,000 |
2,000,000 |
5.10% |
0.68% |
29/11/2024 |
29/11/2025 |
12 |
MyState |
BBB |
1,000,000 |
1,000,000 |
5.15% |
0.34% |
4/12/2024 |
4/12/2025 |
12 |
ING Bank |
A |
1,000,000 |
1,000,000 |
4.80% |
0.34% |
26/02/2025 |
26/02/2026 |
12 |
State Bank of India |
BBB- |
1,000,000 |
1,000,000 |
5.10% |
0.34% |
7/03/2025 |
9/03/2026 |
12 |
State Bank of India |
BBB- |
2,000,000 |
2,000,000 |
5.00% |
0.68% |
10/03/2025 |
10/03/2026 |
12 |
State Bank of India |
BBB- |
2,000,000 |
2,000,000 |
5.00% |
0.68% |
17/03/2025 |
17/03/2026 |
12 |
Total Short Term Deposits |
|
27,000,000 |
27,000,000 |
5.20% |
9.14% |
|
|
|
Medium Term Deposits |
|
|
|
|
|
|
|
|
Westpac |
AA- |
2,000,000 |
2,000,000 |
1.32% |
0.68% |
28/06/2021 |
29/06/2026 |
60 |
Westpac |
AA- |
2,000,000 |
2,000,000 |
1.80% |
0.68% |
15/11/2021 |
17/11/2025 |
48 |
Police Credit Union |
NR |
1,000,000 |
0 |
0.00% |
0.00% |
1/04/2020 |
1/04/2025 |
60 |
ICBC |
A |
1,000,000 |
1,000,000 |
1.85% |
0.34% |
29/05/2020 |
29/05/2025 |
60 |
ICBC |
A |
1,000,000 |
1,000,000 |
1.86% |
0.34% |
1/06/2020 |
2/06/2025 |
60 |
ICBC |
A |
2,000,000 |
2,000,000 |
1.75% |
0.68% |
25/06/2020 |
25/06/2025 |
60 |
ICBC |
A |
2,000,000 |
2,000,000 |
1.75% |
0.68% |
25/06/2020 |
25/06/2025 |
60 |
ICBC |
A |
3,000,000 |
3,000,000 |
5.07% |
1.02% |
30/06/2022 |
30/06/2027 |
60 |
ICBC |
A |
2,000,000 |
2,000,000 |
1.50% |
0.68% |
17/08/2020 |
18/08/2025 |
60 |
BoQ |
A- |
1,000,000 |
1,000,000 |
1.25% |
0.34% |
7/09/2020 |
8/09/2025 |
60 |
BoQ |
A- |
2,000,000 |
2,000,000 |
1.25% |
0.68% |
14/09/2020 |
15/09/2025 |
60 |
ICBC |
A |
1,000,000 |
1,000,000 |
1.20% |
0.34% |
7/12/2020 |
8/12/2025 |
60 |
NAB |
AA- |
2,000,000 |
2,000,000 |
0.95% |
0.68% |
29/01/2021 |
29/01/2026 |
60 |
NAB |
AA- |
1,000,000 |
1,000,000 |
1.08% |
0.34% |
22/02/2021 |
20/02/2026 |
60 |
NAB |
AA- |
2,000,000 |
2,000,000 |
1.25% |
0.68% |
3/03/2021 |
2/03/2026 |
60 |
NAB |
AA- |
2,000,000 |
2,000,000 |
1.40% |
0.68% |
21/06/2021 |
19/06/2026 |
60 |
Westpac |
AA- |
2,000,000 |
2,000,000 |
1.32% |
0.68% |
25/06/2021 |
25/06/2026 |
60 |
ICBC |
A |
1,000,000 |
1,000,000 |
1.32% |
0.34% |
25/08/2021 |
25/08/2026 |
60 |
P&N Bank |
BBB+ |
2,000,000 |
2,000,000 |
4.90% |
0.68% |
11/03/2024 |
11/03/2026 |
24 |
CBA |
AA- |
2,000,000 |
2,000,000 |
3.99% |
0.68% |
4/05/2022 |
5/05/2025 |
36 |
ING Bank |
A |
1,000,000 |
1,000,000 |
5.11% |
0.34% |
23/05/2024 |
25/05/2026 |
24 |
BoQ |
A- |
1,000,000 |
1,000,000 |
4.50% |
0.34% |
7/07/2022 |
7/07/2025 |
36 |
CBA |
AA- |
1,000,000 |
1,000,000 |
4.25% |
0.34% |
12/08/2022 |
12/08/2025 |
36 |
P&N Bank |
BBB+ |
3,000,000 |
3,000,000 |
4.55% |
1.02% |
29/08/2022 |
29/08/2025 |
36 |
Australian Military Bank |
BBB+ |
2,000,000 |
2,000,000 |
4.55% |
0.68% |
2/09/2022 |
2/09/2025 |
36 |
P&N Bank |
BBB+ |
1,000,000 |
1,000,000 |
4.40% |
0.34% |
9/09/2022 |
9/09/2025 |
36 |
ICBC |
A |
2,000,000 |
2,000,000 |
5.20% |
0.68% |
21/10/2022 |
21/10/2025 |
36 |
AMP |
BBB+ |
1,000,000 |
1,000,000 |
4.80% |
0.34% |
21/11/2022 |
20/11/2025 |
36 |
P&N Bank |
BBB+ |
2,000,000 |
2,000,000 |
4.85% |
0.68% |
16/12/2024 |
16/12/2026 |
24 |
Police Credit Union |
NR |
2,000,000 |
2,000,000 |
4.75% |
0.68% |
17/02/2025 |
17/02/2027 |
24 |
P&N Bank |
BBB+ |
2,000,000 |
2,000,000 |
5.00% |
0.68% |
14/03/2023 |
15/03/2027 |
48 |
Auswide |
BBB |
2,000,000 |
2,000,000 |
4.95% |
0.68% |
13/04/2023 |
13/04/2026 |
36 |
P&N Bank |
BBB+ |
2,000,000 |
2,000,000 |
5.20% |
0.68% |
20/04/2023 |
20/04/2027 |
48 |
P&N Bank |
BBB+ |
1,000,000 |
1,000,000 |
5.20% |
0.34% |
26/05/2023 |
26/05/2026 |
36 |
ING Bank |
A |
2,000,000 |
2,000,000 |
5.38% |
0.68% |
28/06/2024 |
28/06/2029 |
60 |
ING Bank |
A |
2,000,000 |
2,000,000 |
5.37% |
0.68% |
21/08/2023 |
21/08/2025 |
24 |
ING Bank |
A |
1,000,000 |
1,000,000 |
4.90% |
0.34% |
29/11/2024 |
29/11/2026 |
24 |
P&N Bank |
BBB+ |
1,000,000 |
1,000,000 |
5.45% |
0.34% |
30/11/2023 |
28/11/2025 |
24 |
ING Bank |
A |
2,000,000 |
2,000,000 |
5.20% |
0.68% |
14/12/2023 |
15/12/2025 |
24 |
ING Bank |
A |
2,000,000 |
2,000,000 |
5.14% |
0.68% |
3/01/2024 |
5/01/2026 |
24 |
P&N Bank |
BBB+ |
2,000,000 |
2,000,000 |
5.10% |
0.68% |
4/01/2024 |
4/01/2027 |
36 |
Suncorp |
AA- |
1,000,000 |
1,000,000 |
5.08% |
0.34% |
8/01/2024 |
8/01/2026 |
24 |
Australian Unity |
BBB+ |
1,000,000 |
1,000,000 |
4.93% |
0.34% |
7/03/2024 |
9/03/2026 |
24 |
ING Bank |
A |
2,000,000 |
2,000,000 |
5.10% |
0.68% |
23/04/2024 |
24/04/2028 |
48 |
NAB |
AA- |
2,000,000 |
2,000,000 |
5.10% |
0.68% |
6/05/2024 |
6/05/2026 |
24 |
ING Bank |
A |
1,000,000 |
1,000,000 |
5.12% |
0.34% |
24/05/2024 |
24/05/2027 |
36 |
ING Bank |
A |
1,000,000 |
1,000,000 |
5.26% |
0.34% |
31/05/2024 |
31/05/2028 |
48 |
ING Bank |
A |
2,000,000 |
2,000,000 |
5.26% |
0.68% |
6/06/2024 |
6/06/2028 |
48 |
Australian Military Bank |
BBB+ |
1,000,000 |
1,000,000 |
5.20% |
0.34% |
11/06/2024 |
11/06/2026 |
24 |
Australian Military Bank |
BBB+ |
2,000,000 |
2,000,000 |
5.20% |
0.68% |
11/06/2024 |
11/06/2026 |
24 |
BankVIC |
BBB+ |
2,000,000 |
2,000,000 |
4.65% |
0.68% |
27/08/2024 |
27/08/2026 |
24 |
ING Bank |
A |
2,000,000 |
2,000,000 |
4.63% |
0.68% |
30/08/2024 |
30/08/2026 |
24 |
ING Bank |
A |
1,000,000 |
1,000,000 |
4.51% |
0.34% |
16/09/2024 |
18/09/2028 |
48 |
Westpac |
AA- |
2,000,000 |
2,000,000 |
4.45% |
0.68% |
27/09/2024 |
28/09/2026 |
24 |
ING Bank |
A |
2,000,000 |
2,000,000 |
4.79% |
0.68% |
17/10/2024 |
19/10/2026 |
24 |
Westpac |
AA- |
1,000,000 |
1,000,000 |
4.70% |
0.34% |
8/10/2024 |
8/10/2026 |
24 |
Westpac |
AA- |
2,000,000 |
2,000,000 |
4.73% |
0.68% |
21/10/2024 |
21/10/2027 |
36 |
Hume Bank |
BBB+ |
2,000,000 |
2,000,000 |
4.95% |
0.68% |
7/11/2024 |
7/11/2026 |
24 |
ING Bank |
A |
2,000,000 |
2,000,000 |
5.02% |
0.68% |
14/11/2024 |
16/11/2026 |
24 |
ING Bank |
A |
1,000,000 |
1,000,000 |
5.00% |
0.34% |
27/11/2024 |
27/11/2026 |
24 |
ING Bank |
A |
2,000,000 |
2,000,000 |
5.07% |
0.68% |
28/11/2024 |
28/11/2028 |
48 |
P&N Bank |
BBB+ |
3,000,000 |
3,000,000 |
4.85% |
1.02% |
16/12/2024 |
16/12/2027 |
36 |
ING Bank |
A |
2,000,000 |
2,000,000 |
4.80% |
0.68% |
21/01/2025 |
21/01/2028 |
36 |
Australian Military Bank |
BBB+ |
1,000,000 |
1,000,000 |
4.82% |
0.34% |
30/01/2025 |
29/01/2027 |
24 |
Australian Military Bank |
BBB+ |
2,000,000 |
2,000,000 |
4.73% |
0.68% |
10/02/2025 |
10/02/2028 |
36 |
Australian Military Bank |
BBB+ |
1,000,000 |
1,000,000 |
4.79% |
0.34% |
4/02/2025 |
4/02/2028 |
36 |
Regional Australia Bank |
BBB+ |
2,000,000 |
2,000,000 |
4.71% |
0.68% |
12/02/2025 |
12/02/2027 |
24 |
Hume Bank |
BBB+ |
2,000,000 |
2,000,000 |
4.75% |
0.68% |
12/02/2025 |
12/02/2029 |
48 |
Westpac |
AA- |
2,000,000 |
2,000,000 |
4.70% |
0.68% |
12/02/2025 |
14/02/2028 |
36 |
ING Bank |
A |
1,000,000 |
1,000,000 |
4.77% |
0.34% |
26/02/2025 |
28/02/2028 |
36 |
ING Bank |
A |
2,000,000 |
2,000,000 |
4.62% |
0.68% |
3/03/2025 |
3/03/2028 |
36 |
State Bank of India |
BBB- |
2,000,000 |
2,000,000 |
4.65% |
0.68% |
14/03/2025 |
15/03/2027 |
24 |
State Bank of India |
BBB- |
2,000,000 |
2,000,000 |
4.65% |
0.68% |
31/03/2025 |
31/03/2027 |
24 |
ING Bank |
A |
0 |
1,000,000 |
4.81% |
0.34% |
1/04/2025 |
1/04/2030 |
60 |
Total Medium Term Deposits |
|
123,000,000 |
123,000,000 |
4.15% |
41.65% |
|
|
|
Floating Rate Notes - Senior Debt |
|
|
|
|
|
|
|
|
Rabobank |
A+ |
2,020,856 |
2,001,182 |
BBSW + 73 |
0.68% |
27/01/2022 |
27/01/2027 |
60 |
Newcastle Permanent |
BBB+ |
1,007,963 |
1,010,601 |
BBSW + 100 |
0.34% |
10/02/2022 |
10/02/2027 |
60 |
ANZ |
AA- |
2,029,412 |
2,034,429 |
BBSW + 97 |
0.69% |
12/05/2022 |
12/05/2027 |
60 |
ANZ |
AA- |
2,554,109 |
2,560,329 |
BBSW + 120 |
0.87% |
4/11/2022 |
4/11/2027 |
60 |
NAB |
AA- |
2,546,839 |
2,553,440 |
BBSW + 120 |
0.86% |
25/11/2022 |
25/11/2027 |
60 |
Suncorp |
AA- |
1,116,927 |
1,119,820 |
BBSW + 125 |
0.38% |
14/12/2022 |
14/12/2027 |
60 |
CBA |
AA- |
2,048,289 |
2,026,372 |
BBSW + 115 |
0.69% |
13/01/2023 |
13/01/2028 |
60 |
Bank Australia |
BBB+ |
1,928,711 |
1,929,071 |
BBSW + 155 |
0.65% |
22/02/2023 |
22/02/2027 |
48 |
Bendigo-Adelaide Covered |
AAA |
1,013,184 |
1,013,814 |
BBSW + 115 |
0.34% |
16/06/2023 |
16/06/2028 |
60 |
CBA |
AA- |
2,531,674 |
2,537,955 |
BBSW + 95 |
0.86% |
17/08/2023 |
17/08/2028 |
60 |
ANZ |
AA- |
2,118,712 |
2,123,212 |
BBSW + 93 |
0.72% |
11/09/2023 |
11/09/2028 |
60 |
Bank Australia |
BBB+ |
1,677,447 |
1,657,962 |
BBSW + 150 |
0.56% |
30/10/2023 |
30/10/2026 |
36 |
ANZ |
AA- |
2,534,847 |
2,540,722 |
BBSW + 96 |
0.86% |
5/02/2024 |
5/02/2029 |
60 |
Suncorp |
AA- |
1,006,177 |
1,006,224 |
BBSW + 98 |
0.34% |
19/03/2024 |
19/03/2029 |
60 |
ING Bank |
A |
503,386 |
504,857 |
BBSW + 95 |
0.17% |
22/03/2024 |
22/03/2027 |
36 |
BoQ |
A- |
1,678,894 |
1,656,793 |
BBSW + 128 |
0.56% |
30/04/2024 |
30/04/2029 |
60 |
Bendigo-Adelaide |
A- |
808,776 |
810,465 |
BBSW + 100 |
0.27% |
14/05/2024 |
14/05/2027 |
36 |
ANZ |
AA- |
1,505,760 |
1,509,726 |
BBSW + 86 |
0.51% |
18/06/2024 |
18/06/2029 |
60 |
Teachers Mutual |
BBB+ |
908,702 |
909,949 |
BBSW + 130 |
0.31% |
21/06/2024 |
21/06/2027 |
36 |
ING Bank |
A |
2,223,267 |
2,225,392 |
BBSW + 102 |
0.75% |
20/08/2024 |
20/08/2029 |
60 |
CBA |
AA- |
1,510,554 |
1,513,953 |
BBSW + 87 |
0.51% |
22/08/2024 |
22/08/2029 |
60 |
Suncorp |
AA- |
2,404,983 |
2,408,607 |
BBSW + 92 |
0.82% |
27/09/2024 |
27/09/2029 |
60 |
Bendigo-Adelaide |
A- |
757,438 |
748,133 |
BBSW + 96 |
0.25% |
24/10/2024 |
24/10/2028 |
48 |
ANZ |
AA- |
1,306,139 |
1,307,675 |
BBSW + 81 |
0.44% |
18/02/2025 |
18/02/2030 |
60 |
Rabobank |
A+ |
1,305,663 |
1,303,843 |
BBSW + 85 |
0.44% |
20/02/2025 |
20/02/2030 |
60 |
The Bank of Nova Scotia |
A+ |
2,004,049 |
1,994,575 |
BBSW + 140 |
0.68% |
21/03/2025 |
21/03/2030 |
60 |
Total Floating Rate Notes - Senior Debt |
|
43,052,759 |
43,009,101 |
|
14.56% |
|
|
|
Fixed Rate Bonds |
|
|
|
|
|
|
|
|
ING Covered |
AAA |
718,878 |
723,784 |
1.10% |
0.25% |
19/08/2021 |
19/08/2026 |
60 |
Northern Territory Treasury |
AA- |
3,000,000 |
3,000,000 |
1.50% |
1.02% |
24/08/2021 |
15/12/2026 |
64 |
BoQ |
A- |
1,846,425 |
1,842,007 |
2.10% |
0.62% |
27/10/2021 |
27/10/2026 |
60 |
BoQ |
A- |
2,081,829 |
2,054,630 |
5.30% |
0.70% |
30/04/2024 |
30/04/2029 |
60 |
ANZ |
AA- |
1,209,290 |
1,227,549 |
4.65% |
0.42% |
18/02/2025 |
18/02/2030 |
60 |
The Bank of Nova Scotia |
A+ |
2,010,890 |
2,035,958 |
5.23% |
0.69% |
21/03/2025 |
21/03/2030 |
60 |
Northern Territory Treasury |
AA- |
2,000,000 |
2,000,000 |
1.50% |
0.68% |
6/08/2021 |
15/12/2026 |
64 |
Northern Territory Treasury |
AA- |
1,000,000 |
1,000,000 |
1.50% |
0.34% |
14/07/2021 |
15/12/2026 |
65 |
Northern Territory Treasury |
AA- |
2,000,000 |
2,000,000 |
1.30% |
0.68% |
29/04/2021 |
15/06/2026 |
61 |
Northern Territory Treasury |
AA- |
2,000,000 |
2,000,000 |
1.00% |
0.68% |
30/11/2020 |
15/12/2025 |
60 |
Northern Territory Treasury |
AA- |
1,000,000 |
1,000,000 |
1.00% |
0.34% |
20/11/2020 |
15/12/2025 |
61 |
Northern Territory Treasury |
AA- |
2,000,000 |
2,000,000 |
1.00% |
0.68% |
21/10/2020 |
15/12/2025 |
62 |
Total Fixed Rate Bonds |
|
20,867,313 |
20,883,929 |
2.32% |
7.07% |
|
|
|
Managed Funds |
|
|
|
|
|
|
|
|
NSW Tcorp |
NR |
2,199,940 |
2,210,429 |
0.48% |
0.75% |
17/03/2014 |
1/04/2030 |
192 |
Total Managed Funds |
|
2,199,940 |
2,210,429 |
0.48% |
0.75% |
|
|
|

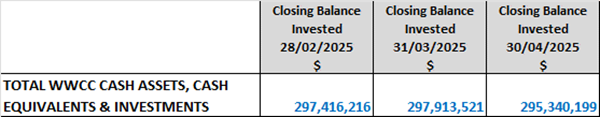

TOTAL CASH ASSETS, CASH |
|
297,913,521 |
295,340,199 |
|
100.00% |
|
|
|
Council’s investment portfolio is dominated by Term Deposits, equating to approximately 51% of the portfolio across a broad range of counterparties. Cash equates to 27%, with Floating Rate Notes (FRNs) around 14%, fixed rate bonds around 7% and growth funds around 1% of the portfolio.
Council’s investment portfolio is well diversified in complying assets across the entire credit spectrum. It is also well diversified from a rating perspective. Credit quality is diversified and is predominately invested amongst the investment grade Authorised Deposit-Taking Institutions (ADIs) (being BBB- or higher), with a smaller allocation to unrated ADIs.
All investments are within the defined Policy limits, as outlined in the Rating Allocation chart below:
Investment Portfolio Balance
Council’s investment portfolio balance decreased over the past month, down from $297.91M to $295.34M.
Monthly Investment Movements
Redemptions/Sales – Council redeemed/sold the following investment securities during April 2025:
Institution and Type |
Amount |
Investment Term |
Interest Rate |
Comments |
Police Credit Union (Unrated) Term Deposit |
$1M |
5 years |
2.20% |
This term deposit was redeemed on maturity and these funds were reinvested in a new 5-year ING Bank term deposit (as below). |
New Investments – Council purchased the following investment securities during April 2025:
Institution and Type |
Amount |
Investment Term |
Interest Rate |
Comments |
ING Bank (A) Term Deposit |
$1M |
5 years |
4.81% |
The ING Bank rate of 4.81% compared favourably to the rest of the market for this term. The next best rate for this term was 4.59%. |
Rollovers – Council did not roll over any investment securities during April 2025.
Monthly Investment Performance
Interest/growth/capital gains/(losses) for the month totalled $980,500, which compares favourably with the budget for the period of $590,254 - outperforming budget for the month by $390,246.
Council’s outperformance to budget for April is mainly due to better than budgeted returns on Councils investment portfolio as well as a higher than anticipated investment portfolio balance – which is partly due to Council receiving upfront payment of $48.5M in AIF funding in June 2024.
Council experienced a positive return on its NSW T-Corp Managed Fund for the month of April, with the fund returning +0.48% (or $10,489) with domestic (+3.62%) shares being the main contributor to performance whilst international (+0.64%) shares were mixed, with a slightly positive overall return.
Cash and At‑Call accounts returned 4.10% (annualised) for the month. These funds are utilised for daily cash flow management and need to be available to meet operating and contractual payments as they fall due.

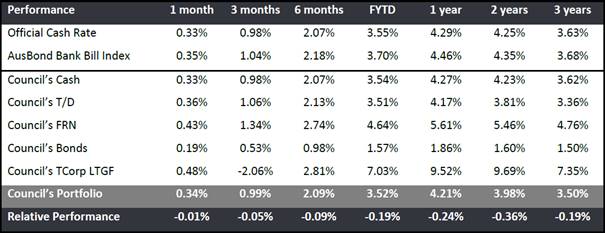

Over the past year, Council’s investment portfolio has returned 4.21%, marginally underperforming the AusBond Bank Bill index by -0.24%. Councils investment portfolio has continued to perform in line with the AusBond Bank Bill Index* over the longer-term time period, returning 3.50% per annum over the past 3 years – slightly underperforming the benchmark by -0.19% over this time.
* The AusBond Bank Bill Index is the leading benchmark for the Australian fixed income market. It is interpolated from the RBA Cash rate, 1 month and 3-month Bank Bill Swap rates.
Report by Responsible Accounting Officer
I hereby certify that all of the above investments have been made in accordance with the provision of Section 625 of the Local Government Act 1993 and the regulations there under, and in accordance with the Investment Policy adopted by Council on 24 June 2024.
Carolyn Rodney
Responsible Accounting Officer
Policy and Legislation
Budget variations are reported in accordance with Council’s POL 052 Budget Policy.
Investments are reported in accordance with Council’s POL 075 Investment Policy.
Local Government Act 1993
Section 625 - How may councils invest?
Local Government (General) Regulation 2021
Section 212 - Reports on council investments
Link to Strategic Plan
Community leadership and collaboration
Objective: Wagga Wagga City Council leads through engaged civic governance and is recognised and distinguished by its ethical decision-making, efficient management, innovation and quality customer service
Ensure transparency and accountability
Risk Management Issues for Council
This report is a control mechanism that assists in addressing the following potential risks to Council:
· Loss of investment income or capital resulting from ongoing management of investments, especially during difficult economic times
· Failure to demonstrate to the community that its funds are being expended in an efficient and effective manner
Internal / External Consultation
All relevant areas within Council have consulted with the Finance Division in relation to the budget variations listed in this report.
The Finance Division has consulted with relevant external parties to confirm Council’s investment portfolio balances.
1⇩. |
Capital Works Program 2024/25 to 2033/34 |
|
Report submitted to the Ordinary Meeting of Council on Monday 26 May 2025 |
RP-5 |
RP-5 Gregadoo Road Corridor Strategy amendment to Wagga Wagga Local Infrastructure Contributions Plan
Author: Belinda Maclure
Executive: John Sidgwick
Summary: |
At their Ordinary Meeting on 24 February 2025, Council resolved to endorse the amendments to TT7 “Gregadoo Road Corridor” in the 2019-2034 Wagga Wagga Local Infrastructure Contributions Plan (LICP) and to place it on public exhibition.
The draft Addendum to the LICP was placed on public exhibition from 21 March 2025 to 2 May 2025 (attached).
The purpose of this report is to provide feedback on the public exhibition and submissions received. |
That Council:
a notes there were two submissions received during the public exhibition period
b adopts the Addendum to the Wagga Wagga Local Infrastructure Contributions Plan 2019 – 2034 to change project TT7 Gregadoo Road Corridor
c process the budget variations listed in the financial implications section of this report after 1 July 2025
Report
On 24 February 2025, at their Ordinary Meeting, Council resolved to:
a endorse the amendments to TT7 “Gregadoo Road Corridor” in the 2019-2034 Wagga Wagga Local Infrastructure Contributions Plan as outlined in the body of this report;
b endorse that the section of Gregadoo Road between Plumpton Road and Main Street be constructed to urban standards (kerb & gutter – 13m wide between kerbs comprising of 2 x 3.5m travel lanes + 2 x 3.0m parking lanes) in any future upgrade of the road and/or intersections;
c endorse that the section of Gregadoo Road between Main Street and Mitchell Road be constructed to rural standards (11m formation comprising of 2 x 3.5m travel lanes + 2 x 2.0m sealed shoulders) in any future upgrade of the road and/or intersections;
d authorise the General Manager or their delegate to place the draft amendment to the Wagga Wagga Local Infrastructure Contributions Plan on public exhibition for a period of 28 days and invite public submissions;
e receive a further report following the exhibition and submission period addressing any submission made in respect of the draft document;
f note that a further report will be provided regarding land acquisitions required to enable implementation of items (a), (b) and (c) above following consultation with land owners along Gregadoo Road.
The report of 24 February 2025 presented an updated Gregadoo Road Corridor strategy. This strategy included changes to the projects identified in the LICP project TT7 Gregadoo Road Corridor. To enable the delivery of a roundabout at the intersection of Gregadoo Road and Plunkett Drive in conjunction with road improvement works along Gregadoo Road between Plumpton Road and Plunkett Drive, it was recommended Council change the Gregadoo/Plumpton intersection works of project TT7 of the LICP to Gregadoo/Plunkett intersection.
A draft Addendum to the LICP was placed on public exhibition from 21 March to 2 May 2025 to change project TT7 Gregadoo Road Corridor Project. During this period two submissions were received regarding issues concerning specific land parcels not effected by the Gregadoo Road upgrade. Officer’s responses to these submissions are provided as a confidential attachment. These submissions do not have an impact on the draft Addendum.
Financial Implications
The changes to the LICP are summarised below.
TT7 Current LICP |
TT7 Addendum to LICP |
1. Road Improvements from Plumpton Road to Plunkett Drive $1,065,000 2. Gregadoo/Plumpton Intersection Upgrade $375,000 3. Gregadoo/Plumpton Intersection (Roundabout) $1,685,000 4. Lakehaven Dve, Tallowood Cr, Main St, Redbank Road, Angela Ave intersection upgrades $1,343,000 Total - $4,468,000 |
1. Road Improvements from Plumpton Road to Plunkett Drive $1,440,000 2. Gregadoo/Plunkett Intersection (Roundabout) $1,685,000 3. Lakehaven Dve, Tallowood Cr, Main St, Redbank Road, Angela Ave intersection upgrades $1,343,000
Total - $4,468,000 |
The amendments to the LICP are proposed to be processed with this Council resolution, and the budget adjustments to the projects will be processed after 1 July 2025, due to the current timing of the draft 2025/26 Long Term Financial Plan.
Policy and Legislation
Budget variations are reported in accordance with Council’s POL 052 Budget Policy
Wagga Wagga Local Infrastructure Contributions Plan 2019 – 2034
Link to Strategic Plan
Growing
Enabling infrastructure
Provide essential infrastructure; including sewer, roads, key housing enabling infrastructure to support growth.
Risk Management Issues for Council
The draft Addendum to the LICP is a risk mitigation strategy to ensure Section 7.11 contributions collected for the upgrade of Gregadoo Road are allocated effectively.
Internal / External Consultation
The draft Addendum was placed on public exhibition from 21 March to 2 May 2025.
Two submissions were received which raise specific issues relating to private property not impacted by the Gregadoo Road upgrade project. Arrangements have been made for the project manager to speak to these land holders about their submissions.
1⇩. |
Draft Addendum - Wagga Wagga Local Infrastructure Contributions Plan 2019-2034 Change to Gregadoo Road Corridor Project TT7 |
|
2⇩. |
Gregadoo Road Corridor Strategy Amendment to Wagga Wagga Local Infrastructure Contributions Plan Submissions and Response |
|
Report submitted to the Ordinary Meeting of Council on Monday 26 May 2025 |
RP-6 |
RP-6 EXTENSION OF RFT 2023-13 PLACEMENT OF INSURANCE AND PROVISION OF RISK ADVISORY SERVICES
Author: David Galloway
Executive: Scott Gray
Summary: |
Council is seeking to exercise a contract extension for Insurance and Risk Advisory Services provided by JLT Risk Solutions Pty Ltd. |
That Council authorise the General Manager or their delegate to extend the Contract for RFT 2023-13 for Insurance and Provision of Risk Advisory Services with JLT Risk Solutions Pty Ltd (ABN 69 009 098 864) for three 12-month periods at the sole discretion of Council.
Report
Contract RFT 2023-13 was originally awarded to JLT Risk Solutions Pty Ltd (ABN 69 009 098 864) following a successful tender process and endorsed by Council on 1 May 2023 (Resolution 23/058).
The initial contract term was for two years from 1 July 2023 to 30 June 2025, with an option to extend by 3 x 12-months. The authority to exercise the extension options was omitted from the original resolution.
Given the oversight in the resolution, it is necessary to now seek formal endorsement by Council for the extension periods to ensure the contract remains compliant with procurement and governance frameworks.
Financial Implications
The extension will be funded within the existing approved budget allocation for the relevant service area.
Policy and Legislation
Local Government Act 1993
Link to Strategic Plan
Regional Leadership
Good governance
Provide professional, innovative, accessible and efficient services.
Risk Management Issues for Council
To ensure continuity of coverage, the insurance policies in Council’s portfolio are required to commence with an effective date of 4.00pm on 30 June 2025.
Internal / External Consultation
N/A
Report submitted to the Ordinary Meeting of Council on Monday 26 May 2025 |
RP-7 |
RP-7 QUESTIONS WITH NOTICE
Author: Scott Gray
Summary: |
This report is to respond to questions with notice raised by Councillors in accordance with Council’s Code of Meeting Practice. |
That Council receive and note the report. |
Report
The following questions with notice were received prior to the meeting, in accordance with the Code of Meeting Practice.
Councillor T Koschel
What is Council’s stance on collecting Firewood from the side of Roads? |
Council’s current position is guided by the Local Government Act 1993, Section 629 advising it is prohibited to remove plants, animals, rocks and soil fr |
